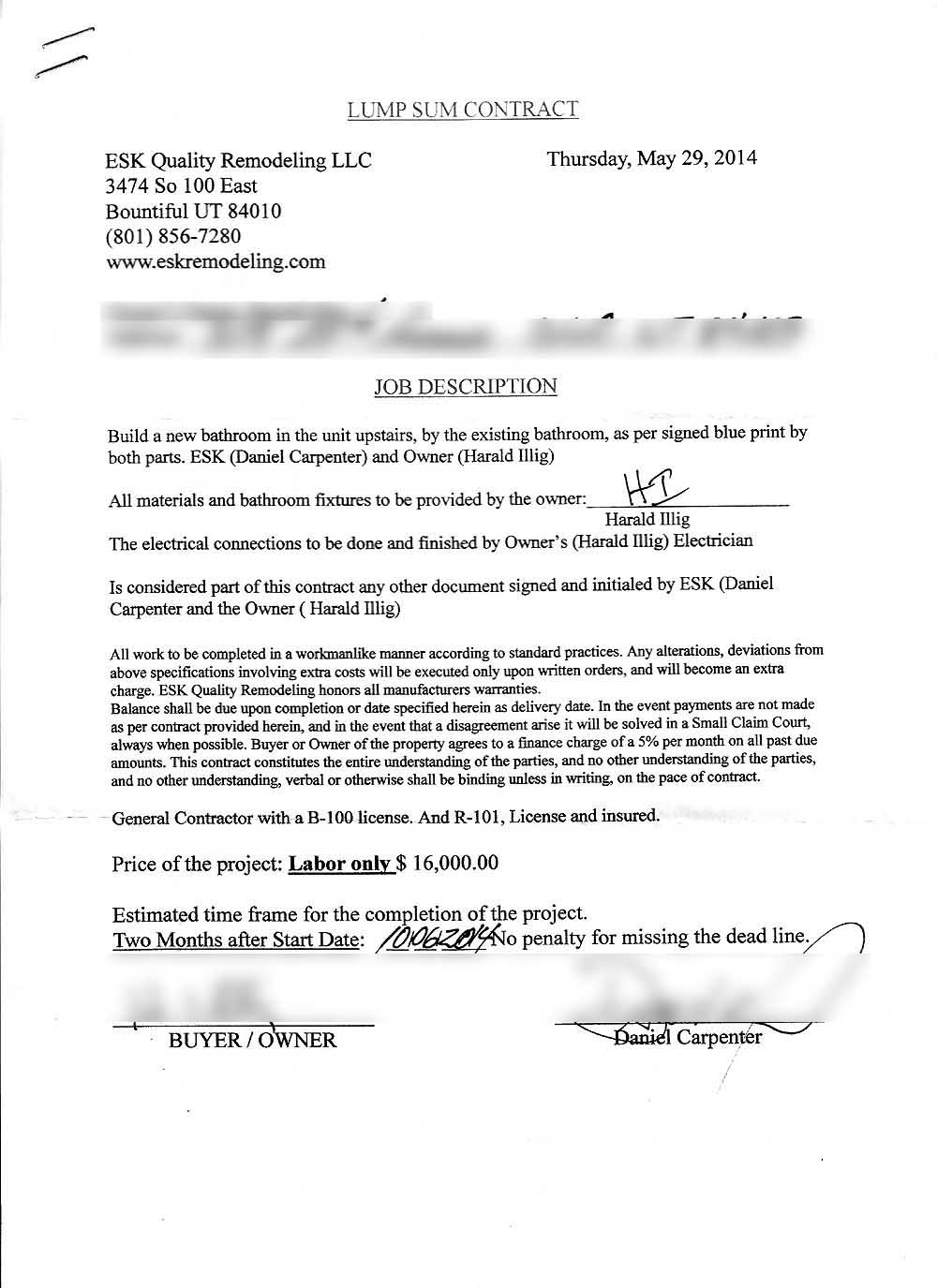

Contract | |
|
|
(Initialed paper copy on file) | |
This project is to be "turn-key" completed, 100% ready for use at time of final payment. "THESE DIAGRAMS REPRESENT THE MAIN IDEA of WHAT IS TO BE DONE" |
|
1 |
|
2 |
Quality of construction and precision of workmanship is important! |
15
|
Doors. Hallway door is to be relocated to the east and the existing doorway area, floor
walls, ceiling is to be refinished so that the old doorway does not
remain. Bathroom shall have a new door. There shall be a door
stop. [ 00 - See diagrams / Blueprint] |
20 | "Medicine" Cabinet. A corner medicine cabinet shall be installed over the sink. Another cabinet have shall a door with magnetic latches, and it shall have at least two shelves. Cabinet is to extend into shelf area of an existing cabinet in the adjacent bathroom. A Finish Carpenter may be required to accomplish this or an appropriately sized door may be purchased by contractor, with client approval. |
25 |
Mirrors. 1.) East wall shall have a large mirror commencing from 4ft above floor to ceiling. Area behind mirror is to be painted the same as the other walls. 2.) The corner medicine cabinet's door over the sink has a mirror which is to cover the door entirely [see diagram]. |
27 |
Windows.
The 6 in foot span at North wall
of the house represents an existing window which is to be split: 1.) A brick partition 12 in maximum width is to be constructed to split the existing window in two; bricks are to match the exterior bricks of the house as closely as possible - re-use existing bricks. Brick work is to be staggered. 2.) Glass Block is to be used for lower bathroom window; 3.) Upper double pane bathroom window hinges toward inside (awning window) at top; 4.) A standard single or double-hung window for the existing adjacent bedroom; 5.) Bathroom window has a (marble) window sill of width 4.5' |
30 |
Shelves & Sills. 1.) A MARBLE window sill of width 4.5in is at the foot the Glass Block Window. 2.) A corner medicine cabinet is to be installed over the sink. A marble sill of width 5- ½'. is to be under this medicine cabinet above the corner sink. 3.) Shower walls and shower-partition wall between shower and toilet area is to have recessed shelves as per blueprint. These In-wall tiled shower shelves are tiled and have MARBLE sill; height of recessed shelves is 12'. |
32 |
Wall &
Insulation. 1.) The existing, partially constructed wall is to be insulated, R13 minimum and North shower wall is to have R13-insulation added - none exists at present. |
35 |
Tiles & Cladding materials. Cladding
materials for floor, walls and ceiling are to be determined by
customer in consultation and agreement with contractor. 1.) Bathroom floor and shower floor is to be tiled. 2.) Shower walls and ceiling are to be tiled. 3.) Remainder of bathroom walls are to be tiled to a height of 4 ft w/ "bull-nose". 4.) Recessed selves shall have a ledge / sill and shall be tiled or have a marble sill. The soap holders are to be installed into the tiled walls [See Order URL]. |
38 | Paint. Upper walls and bathroom ceiling (1 coat primer 2 coats of oil paint) are to be painted; remodeled area in hallway (where the old door was and where the new electrical panel is) are to be painted similarly. |
39 | Bathroom floor and shower area shall have a waterproof underlayment which extends at least six (6) inches upward against all wall sections. Floor slopes towards linear drain and also slopes from behind the partition wall. |
40 | Entrance. Entrance may be raised above existing hardwood floor of hallway approximately 1 in; a raised threshold or marble "lip" to prevent outflow of water onto hallway floor is to be installed. A wedge-shaped ramp is needed in hallway. |
41 | Fixtures. Urinal, Wall-hung toilet, in-wall tank with ( no Access Panel), Louvres, Flush Actuator, Wall hung shelf, towel racks, towel ring, towel bars, curtain rod, coat hangers, Soap dishes tile, hose bib, etc. [See diagrams and Order URL]. |
42 |
Shower
fixtures. Overhead shower, Wall-mounted Body Spray
(2 ea.) Slide bar Wand Shower (optional) [See parts at
Order
URL]. Automatic Thermostatic shower valve - set water temperature if possible. |
43 | Hose. Hose connector (Hose bib) for cleaning the bathroom (no sweeping:) -location to be determined. |
45 | Floor drain. One linear floor drain shall be installed to separate the shower area from the toilet area [See diagram and parts at Order URL]. |
47 | Heating ducts. Air from a duct in existing bedroom is to be split as to divert part of the air flow into the new bathroom and an air duct is to remain in the existing bedroom. |
49 | Plumbing. Plumbing is to be copper (not PEX). |
53 | Circuit breaker box. Sheetrock near box needs to be repaired and repainted. |
~ Electrical ~ |
|
NB: Electrical work has already been contracted - JP Electric. |
|
Electrical. [Contractor is JP Electric] New Circuit Breaker Box to service the new bathroom and the existing wiring of the unit. A multitude of ceiling and other electrical lamps and electrical outlets are to be provided [See electrical diagram). East wall is to have electrical outlets and switches to serve bedroom. |
|
NowScape.com
